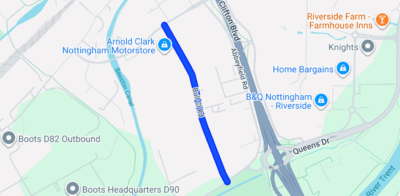

Nottingham City Council will be investing Local Transport Plan funding from Central Government to improve Bull Close Road and its pavements. This road provides access to businesses in the Dunkirk Industrial area but is currently not part of the adopted highway network.
What’s happening
Starting 5 January 2026 and continuing through autumn, works will include:-
- Reconstruction of roads and pavements
- Installation of new street lighting
- Improved accesses to business premises
- Informal pedestrian crossing points introduced with tactile paving
- Improved drainage, including replacement of a 100m section of surface water main
Once all works have been completed, a new 20mph speed limit will be in place and no waiting at any time restrictions in areas that currently have no parking restrictions.
Phasing and Access
To maintain business and pedestrian access, works will be delivered in 10 phases under rolling road closures. Each phase will take approximately 2–3 weeks and include kerb, drainage, and pavement reconstruction.
- Phase 1: Thane Road to Aston Martin access
- Phase 2: Aston Martin access to Goodman Retail northern access
- Phase 3: Goodman Retail to PowerPark northern access
- Phase 4: PowerPark northern access to Imperial Tobacco
- Phase 5: Imperial Tobacco to Sunbelt Rentals*
- Phase 6: Sunbelt Rentals to JK Foods HGV access
- Phase 7: JK Foods HGV access to JK Foods Customer entrance
- Phase 8: JK Foods Customer entrance to JK Foods Customer exit
- Phase 9: JK Foods Customer Exit to ZF access
- Phase 10: ZF access to Redfield Road
Vehicle access to all businesses will be maintained throughout however there will be diversions in place – these will be clearly signed on site and updates will be provided regularly.
Works will take place Monday to Friday 8am – 5pm. Parking will be suspended on Abbeyfield Road for the duration of the works to accommodate diversion traffic; alternative parking arrangements are advised.
* Phase 5 includes the section of surface water main that needs to be replaced – this road closure may be in place for up to 6 weeks involving deep excavations in the road.
Once Phase 10 is nearing completion, reconstruction of the road will commence – more information will be provided nearer to the time.
We appreciate your cooperation during these essential improvements and will keep you informed as the project progresses.
